CPU AND STORAGE · 20–300 KW IT LOAD

Modular data centers for enterprise and edge workloads.

Air-cooled modular data centers combine protected power, IT space and monitoring for CPU servers, storage and local services. Configure the facility around your enterprise or edge computing requirements.

20–300 kW
Current IT-load range; configured by project
CPU + storage
Target equipment
Air cooling
Selected for the equipment and climate
2N or N+1
architectures by model
FAT + site acceptance
Agreed testing before handover

Enterprise and edge capacity at your site.

Run business applications, retain storage near the systems that use it, or add capacity to an existing site. Power, cooling, access and monitoring are designed around that job.

The current product direction covers 20–300 kW IT load. The catalog configurations below provide established starting points; higher-capacity projects need their own rack, power and cooling design.

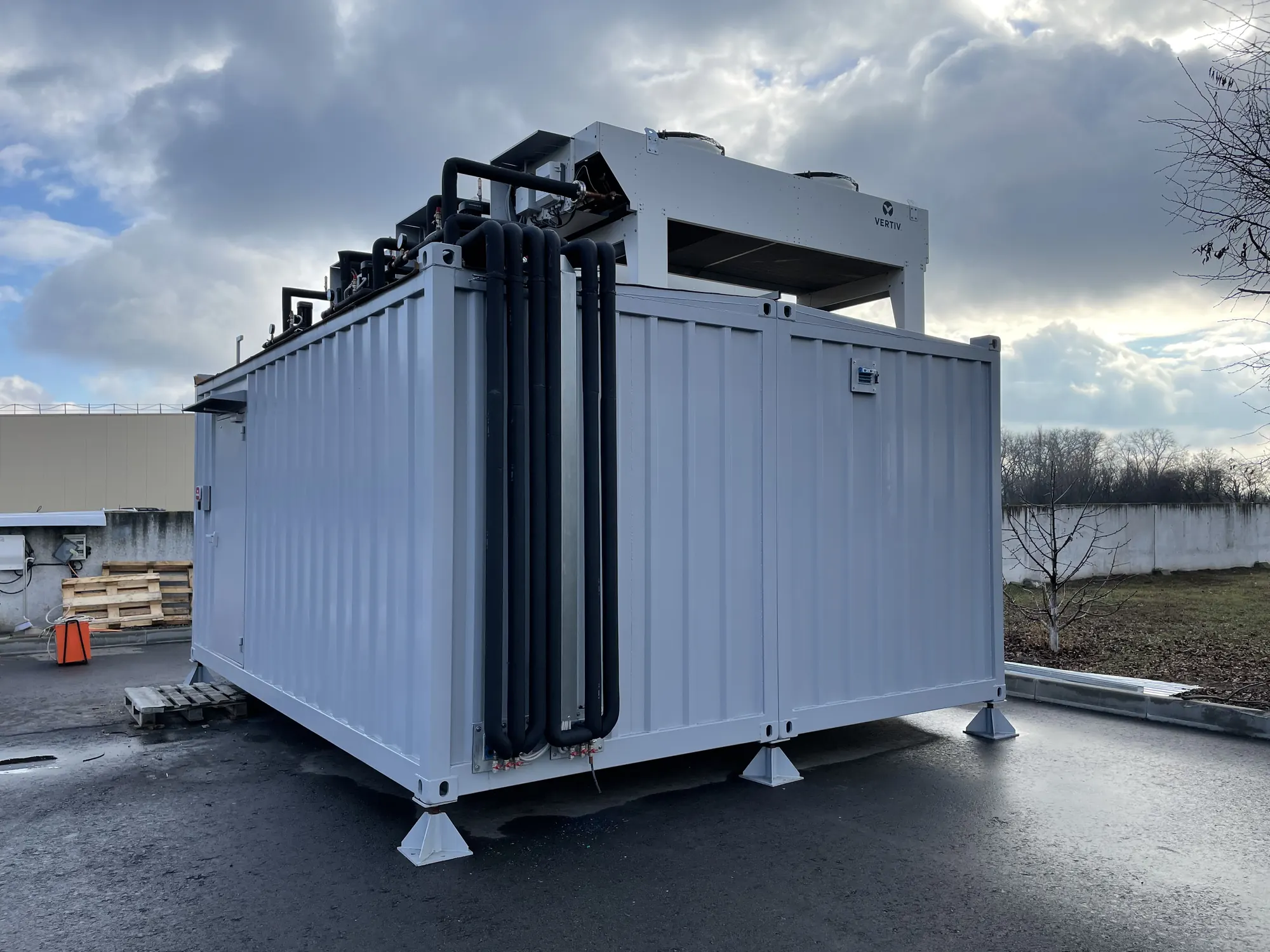

A white ModulEdge modular data center with rooftop cooling equipment on an outdoor pad
A ModulEdge module

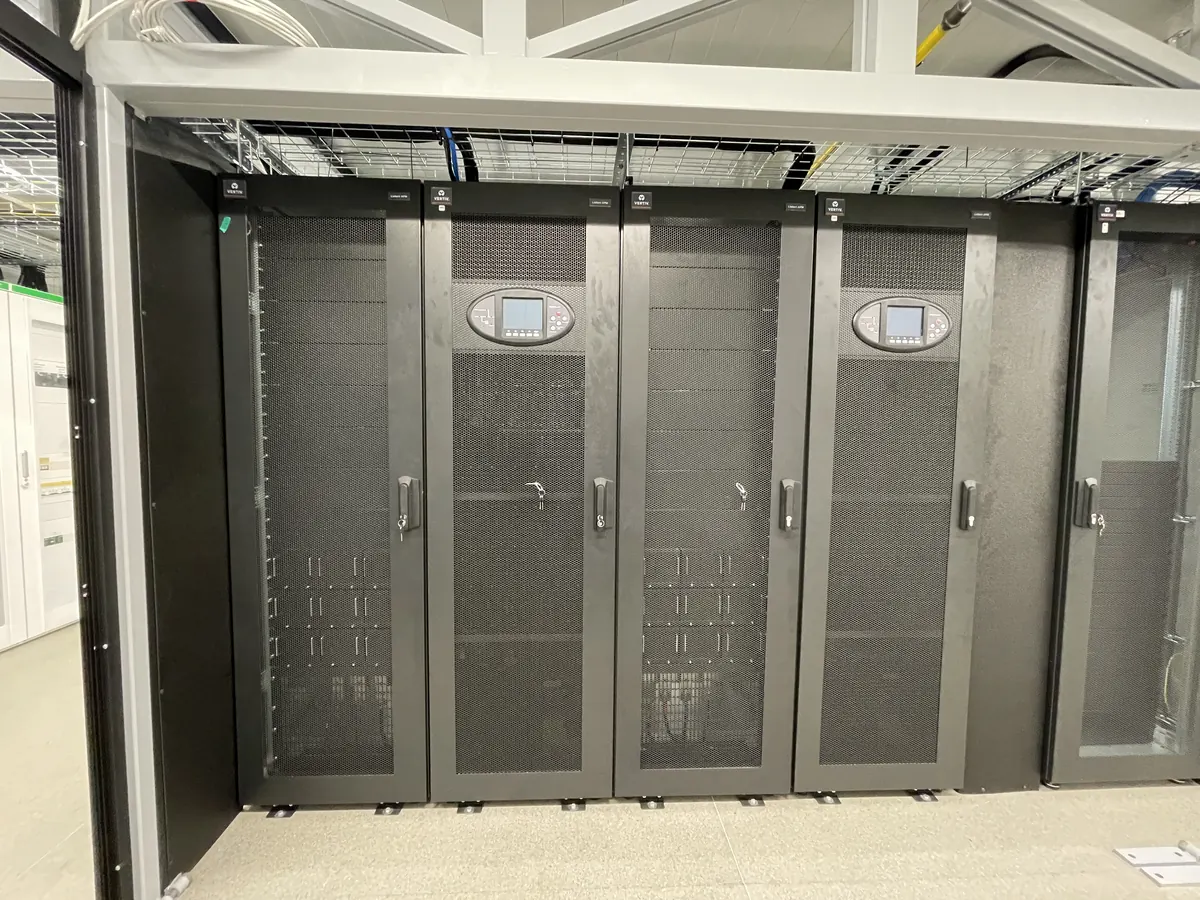

A row of server racks with perforated doors inside a module
Rack row inside the module

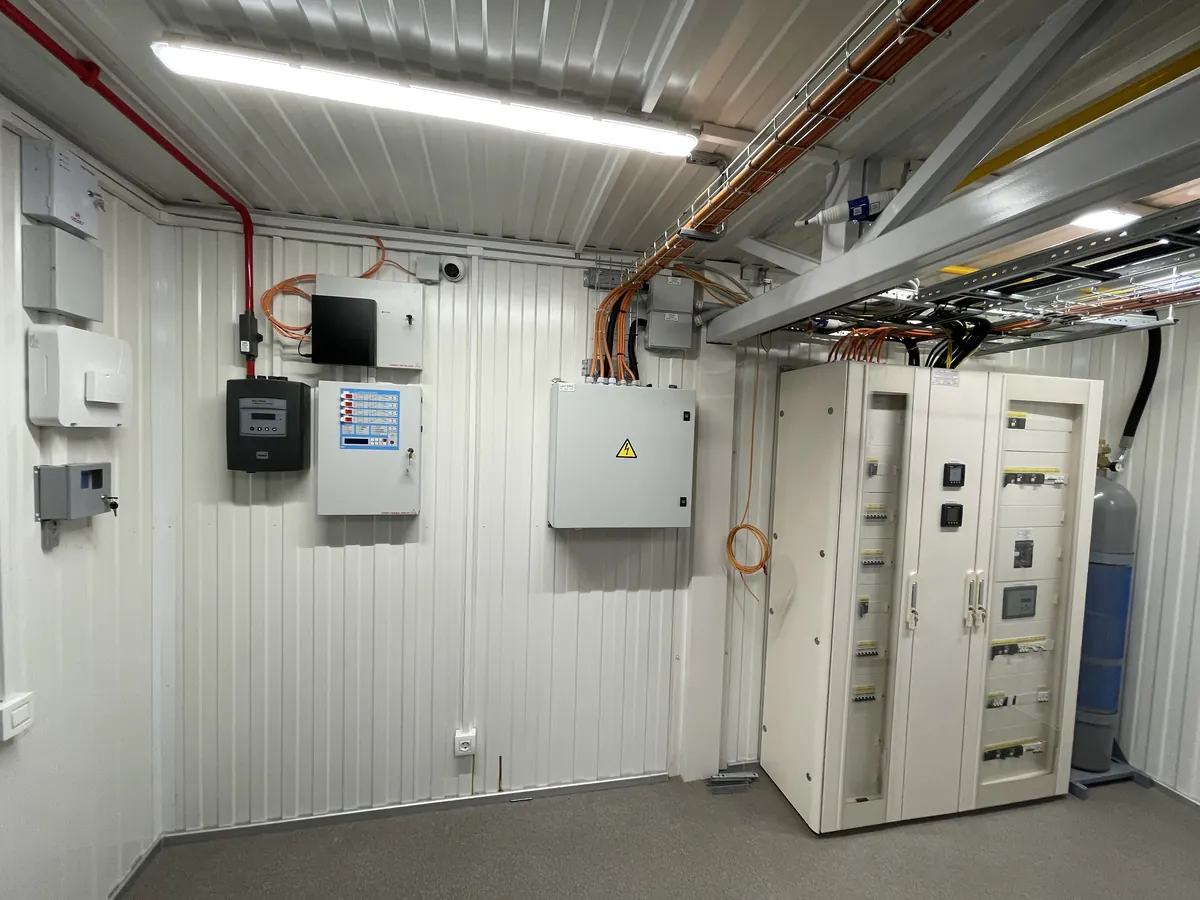

Electrical distribution cabinets mounted beside the IT racks inside a module
Power distribution beside the racks

Start with a catalog configuration.

  1. Type XS

    20 kW IT · 2 × 42U racks · full 2N power

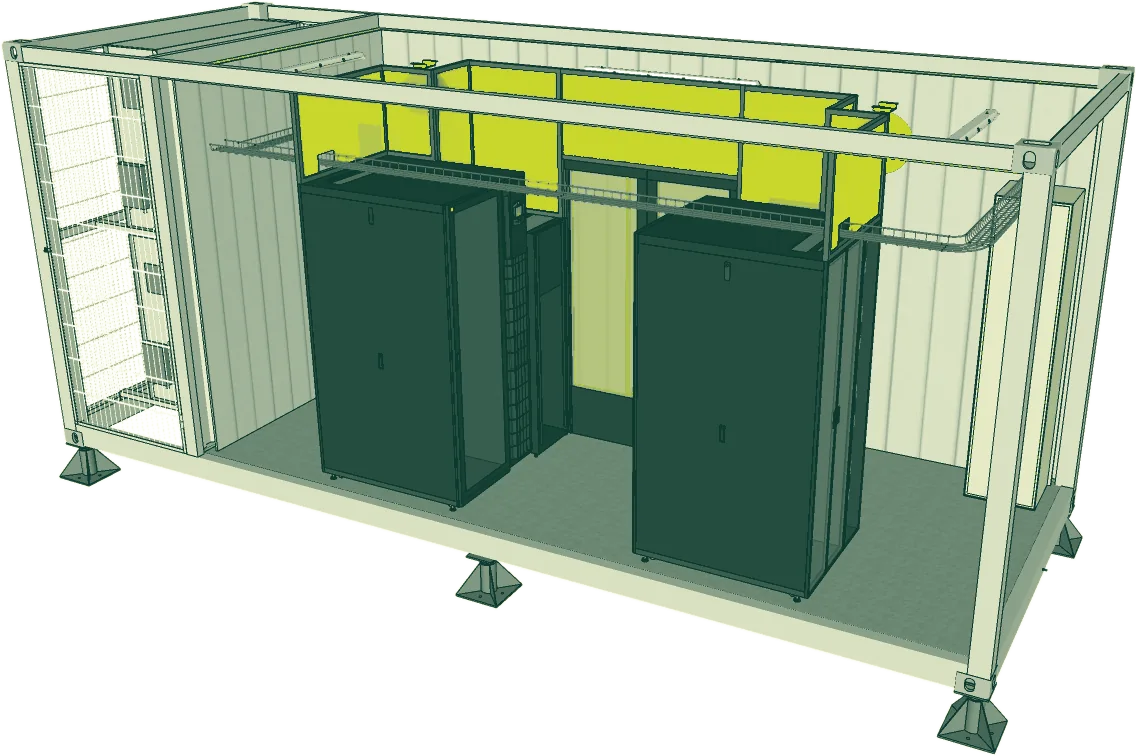

    Type XS cutaway: racks, power and cooling inside the module

    The smallest system in the range. Two independent UPS strings and dual rack distribution protect edge deployments where power-path separation matters more than expansion space. Baseline battery autonomy is 15 minutes at full IT load, sized to generator transfer or extended by request.

    Cooling: in-row precision air conditioning

    Best fit: compact edge nodes and critical local services

  2. Type S

    40 kW IT · 3 × 42U racks + telecom · N+1

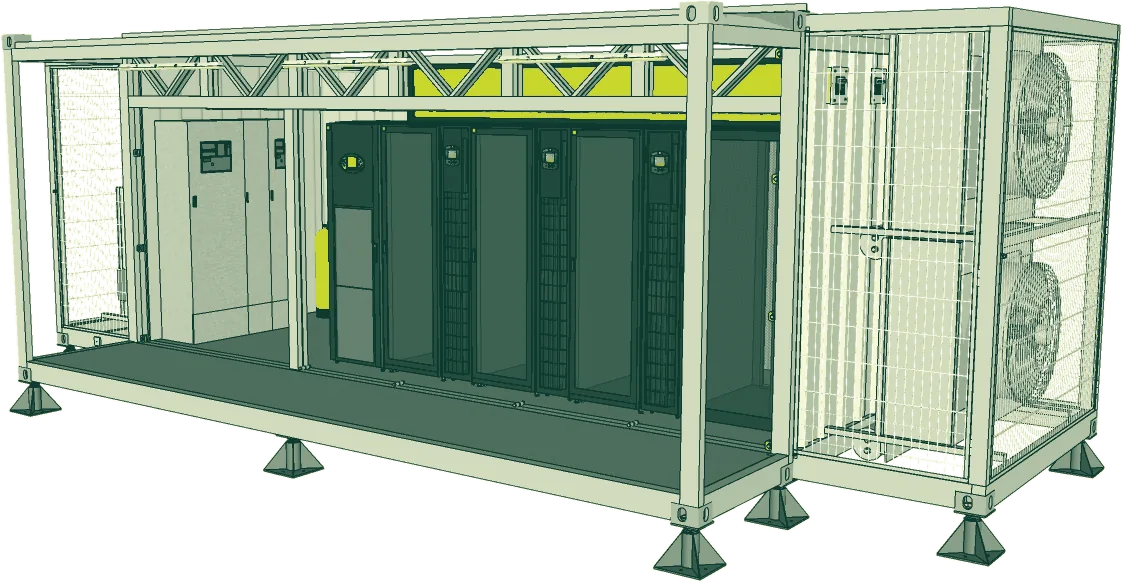

    Type S cutaway: racks, power and cooling inside the module

    A compact branch or edge data center with a dedicated telecom cabinet, modular UPS and N+1 precision cooling. Baseline battery autonomy is 10 minutes at full IT load, with longer runtime available by project.

    Cooling: precision air conditioning with N+1 units

    Best fit: branch infrastructure and local application platforms

  3. Type M

    80 kW IT · 9 × 42U racks + telecom · N+1

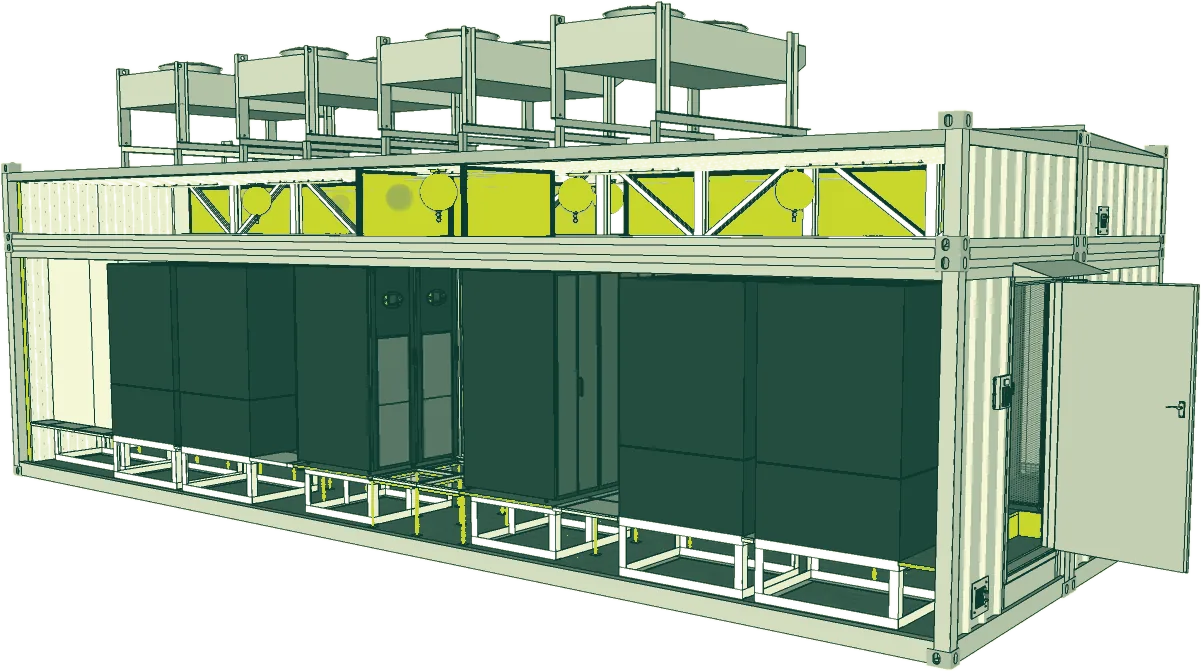

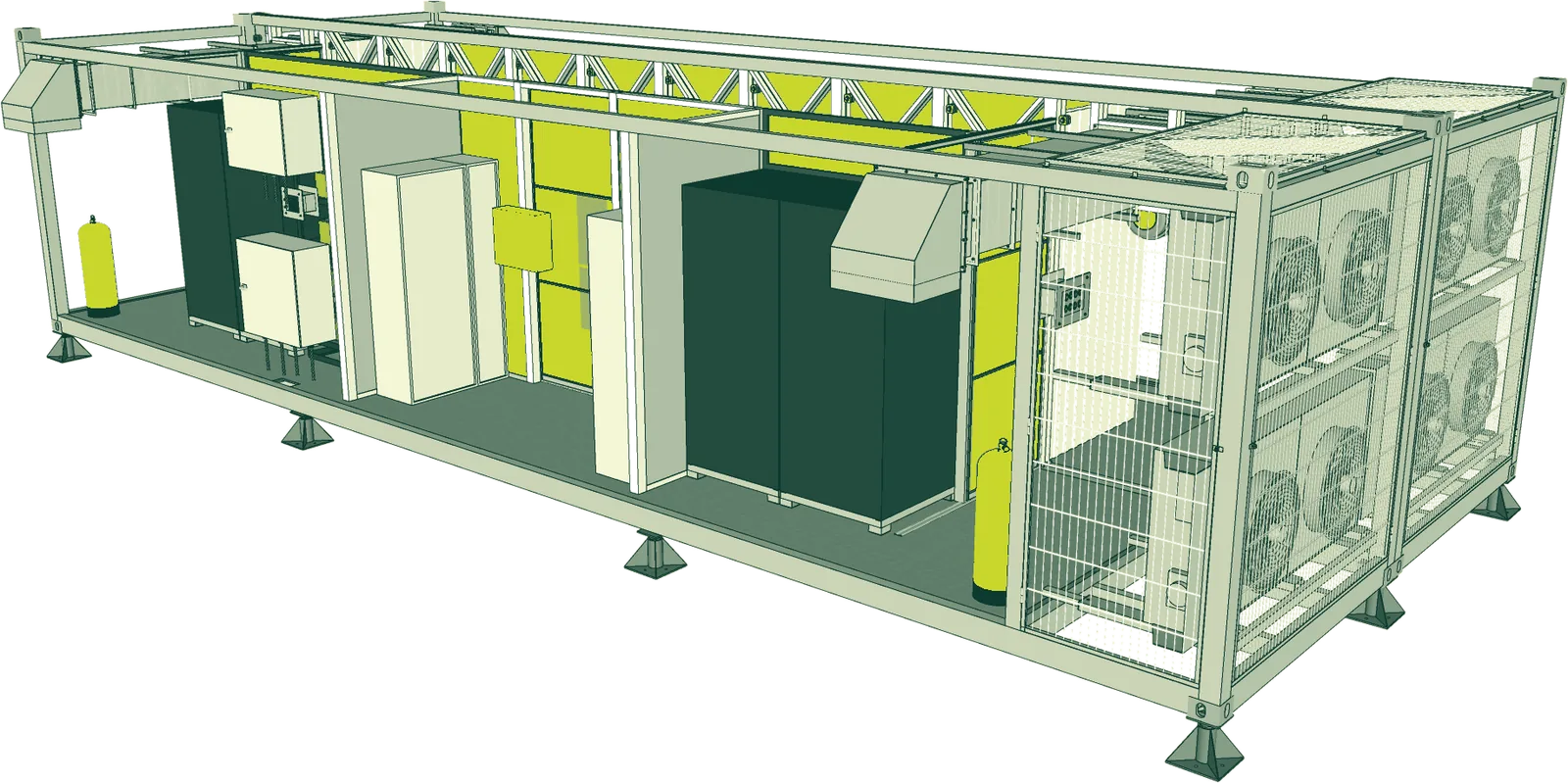

    Type M cutaway: racks, power and cooling inside the module

    A mid-range system with a separate entrance chamber and indirect free cooling. Cabinet-mounted precision air conditioners take over when ambient conditions cannot carry the load.

    Cooling: indirect free-cooling unit + N+1 cabinet precision AC

    Best fit: mid-sized enterprise and regional edge capacity

  4. Type L

    120 kW IT · 14 × 42U racks + telecom · N+1

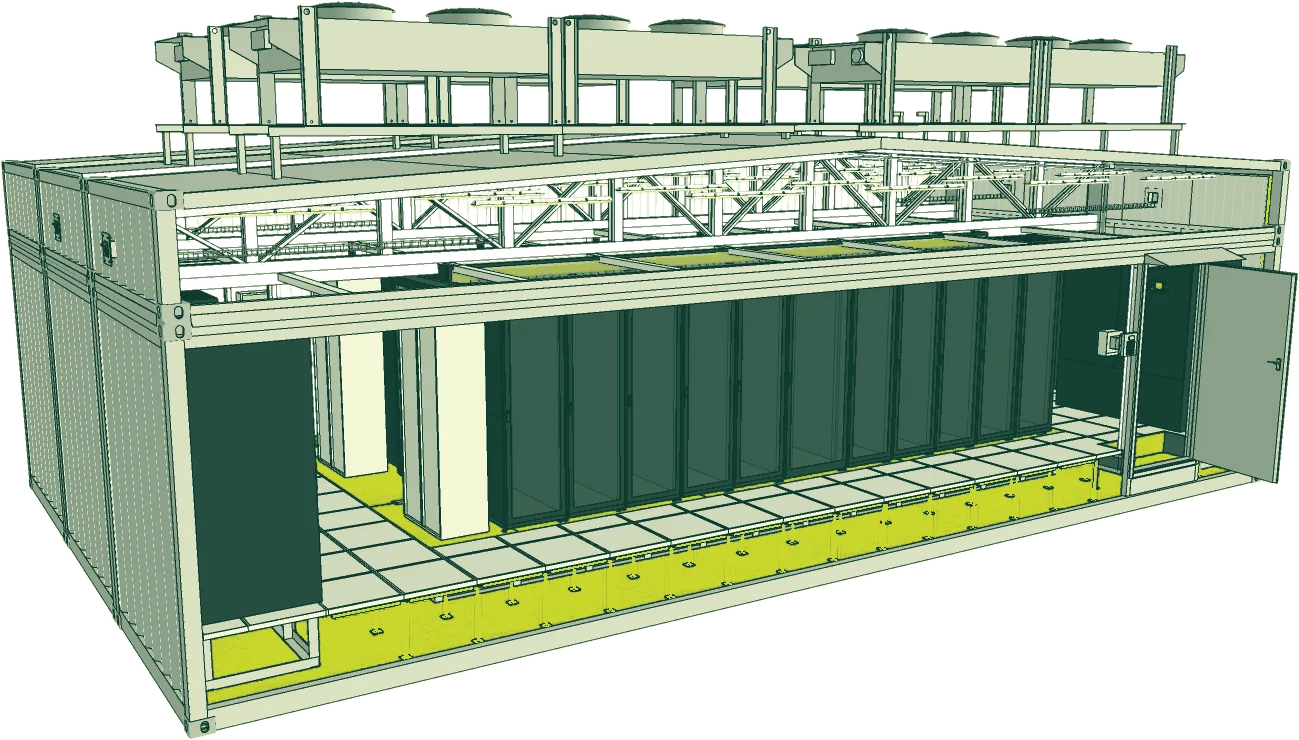

    Type L cutaway: racks, power and cooling inside the module

    The largest integrated single-module configuration. A raised technical floor supports service distribution. Climate-suitable sites can use direct free cooling, with mechanical cooling for peak conditions.

    Cooling: N+1 direct free cooling with mechanical backup

    Best fit: dedicated enterprise platforms and larger on-premises estates

  5. Type XL

    200 kW baseline · 20 × 42U racks + 2 telecom · N+1

    Type XL cutaway: racks, power and cooling inside the module

    The companion Power Module: UPS strings, batteries and switchgear in their own module
    Power Module

    Type XL separates the IT space from a dedicated Power Module. Transformers, MV/LV switchgear, modular UPS and batteries stay in their own electrical room. A defined power-and-cooling uplift takes the platform to 264 kW.

    Cooling: mechanical baseline; direct free cooling optional at suitable sites

    Best fit: fixed sites that need a clear expansion path

Catalog configurations at a glance

ModelIT loadServer racksTelecomPower redundancyCooling
Type XS20 kW2OptionalFull 2NIn-row precision air conditioning
Type S40 kW31N+1Precision air conditioning, N+1
Type M80 kW91N+1Indirect free cooling + precision AC, N+1
Type L120 kW141N+1Direct free cooling + mechanical backup, N+1
Type XL200 kW baseline; up to 264 kW with uplift202N+1; dual paths available by requestMechanical baseline; direct free cooling optional

These issued catalog configurations retain their own ratings, rack counts and options. The broader 20–300 kW product direction does not change a Type XL rating or make 300 kW a standard upgrade.

Put the workload close to the operation.

Local capacity can serve latency, connectivity, continuity or control requirements. Select the facility around the reason the equipment needs to be there.

01

Latency

Process control, local analytics or interactive systems cannot wait for a distant region.

02

Bandwidth

Data is generated locally, and sending all of it upstream is expensive or impractical.

03

Continuity

The site must retain critical capability when external connectivity is constrained.

04

Control

The organisation needs a defined physical, operational or data-residency boundary.

Share the applications and storage requirements so we can assess the right capacity and operating model.

Plan the facility’s site interfaces.

Check the selected enclosure, delivery route and service clearances alongside the equipment, power and cooling requirements.

  • Rack dimensions, load distribution and airflow
  • Incoming power and generator interface
  • Battery autonomy and UPS topology
  • Climate, cooling mode and heat rejection
  • Fire-detection and suppression design
  • Monitoring, BMS/DCIM and alarm integration
  • Physical security and maintenance access
  • Local codes, delivery route and foundations

Keep power work out of the white space.

In Type XL, transformers, switchgear, UPS and batteries sit in a separate electrical room. Power-equipment heat stays outside the IT cooling path. Technicians can service the power system without entering the white space.

The 264 kW configuration is an engineered uplift, not the default Type XL rating. Cooling and Power Module capacity must be upgraded together.

Factory assembly and site commissioning.

  1. 01

    Select the closest model.

    Match IT load, rack count, density and resilience.

  2. 02

    Complete the interfaces.

    Resolve utility, cooling, network, civil, security and site access.

  3. 03

    Build and factory-test.

    Integrate the agreed power, cooling, protection and control systems, then execute the defined FAT.

  4. 04

    Install and commission.

    Connect at site, complete SAT and verify the operating system before handover.

The factory and site programmes can run in parallel. Final timing depends on the configuration, equipment availability, logistics, civil readiness and approval path.

Bring what you know.

  • Rack list, dimensions and expected population
  • Total IT load and peak load by rack
  • Site plan, access route and maintenance envelope
  • Available power and upstream backup strategy
  • Connectivity and telecom requirements
  • Climate and environmental conditions
  • Availability objective and maintenance philosophy
  • Initial date, future growth and any planned capacity phases

You do not need a finished specification. The first review is where we find the missing decisions.

Frequently asked questions

What are conventional modular data centers used for?

ModulEdge's conventional range provides local infrastructure for CPU servers, storage and networking. Typical applications include enterprise IT, edge sites and systems that need dedicated capacity close to their operations. It is an air-cooled product route, distinct from the higher-density AI configurations.

What IT capacity does the conventional range offer?

The published conventional range covers 20–300 kW of IT load, configured around the equipment and site. Rack count and maximum load per rack are selected together. Total IT capacity is separate from the site power required for cooling, electrical losses and other facility systems.

Is a conventional modular data center the same as a container data center?

A container data center uses a defined transportable enclosure; a modular facility can also be assembled from purpose-built technical sections. The selected conventional configuration determines the enclosure, dimensions and transport method. Confirm those details from the project layout rather than assuming every model fits one shipping container.

What must the site provide before installation?

Plan foundations, available electrical supply, fibre connections, delivery and lifting access, and space to operate and maintain the facility. Cooling equipment and service routes also need room outside the IT enclosure where specified. The issued site layout sets the loads, clearances and connection points.

Can the module use our existing power and monitoring systems?

Existing UPS, generator, power distribution or monitoring systems can be considered during the interface review. Share their ratings, topology, controls and operating constraints. The design must establish which equipment remains in use, what new equipment is needed and how the combined system will be tested.

Can a conventional modular data center be moved or expanded later?

Relocation and expansion can be included in the original brief. Transport dimensions, lifting points, foundations and reconnection work need to support a future move; power, cooling and fibre capacity need to support growth. These provisions are configuration-specific, rather than automatic features of every modular installation.

What affects the price of an enterprise or edge modular data center?

The main inputs are IT load, rack population, cooling duty, UPS and battery scope, redundancy, enclosure requirements and site interfaces. Civil works, upstream electrical equipment, transport and installation should be identified separately. A 20 kW edge site and a 300 kW enterprise deployment need different scope and cost assumptions.

What is tested before a conventional modular data center is handed over?

Factory acceptance testing checks the agreed electrical, cooling, protection, monitoring and alarm functions before shipment. Site acceptance and commissioning then verify the installed facility and its utility and network interfaces. Test criteria and any required failure or maintenance scenarios belong in the acceptance plan.
